Oct 31 – Retaining Wall and Footings Rebar Installed

header

Today the rebar people came in to start the installation of the rebar in the bottom floor retaining wall and footings forms. The rebar people should finish this part of their work tomorrow. Then the lake side of the retaining wall form needs to be completed and the forms inspected. The current plan is to pour the bottom floor retain wall and footings next Monday.

Oct 28 – Wall footing forms added

header

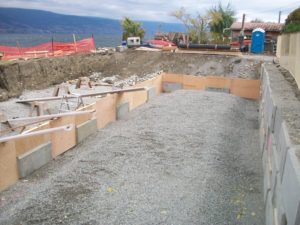

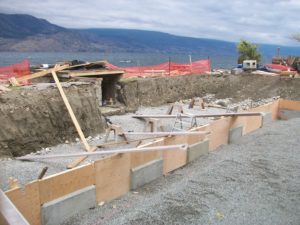

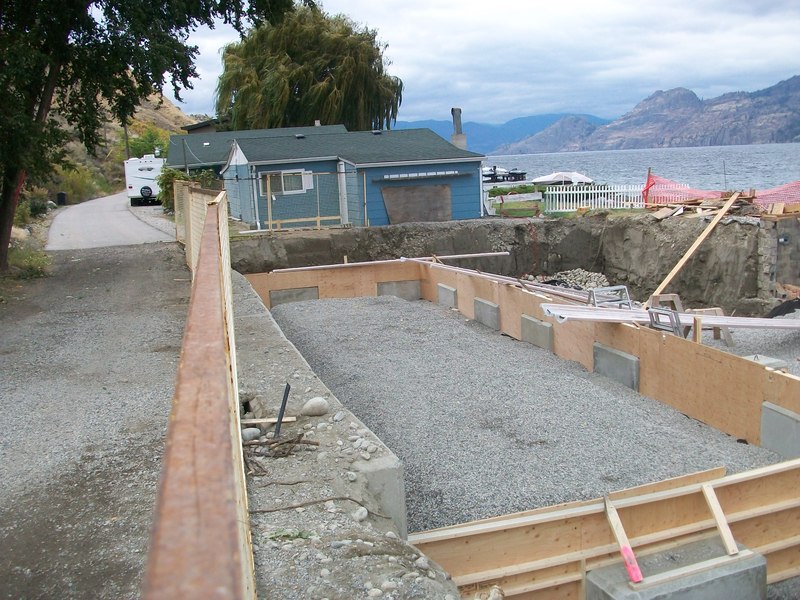

Today the crew had a nice sunny day to place the forms for the exterior and interior concrete walls. Hopefully the weather will stay warm for the next concrete pour.

The door on the road side of the building will be a bit higher than we had originally planned because the whole foundation had to be raised for geo-technical reasons. However, our builder doesn’t see that it will be a problem once we get the final grading in place.

Oct 24 – Footing forms removed

header

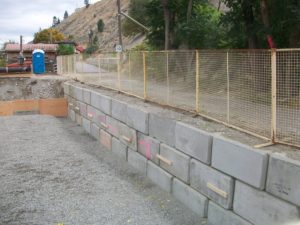

The crew was in early this morning removing the forms. Once they were removed, the rock slinger returned to start filling up the hole. Our builder expects a couple of days of rock slinging to get up to the needed height.

We had a bit of a surprise when we checked the amount of concrete that went into the footing. The calculated amount was 63 cubic meters but the actual was 85 cubic meters at almost $200 per cubic meter. Our builder says that the concrete could have seeped into the gravel underneath and the centre of the footing may not have been built up enough.

Our geo-tech is looking into why an excessive amount of geo-tech fabric was ordered by one of his guys. Hopefully we will get a solution to this soon.

Oct 20 – Retaining wall footing was poured today

We met with our builder just after the last load of concrete was placed. Apparently it was quite an adventure getting the rebar in place and the inspections done before the concrete could be poured. Yesterday, the rebar people didn’t show up until later in the morning even though the structural engineering inspection was scheduled for 1:00. The rebar people did not finish until late Wednesday which required that the engineer return this morning to complete the inspection.

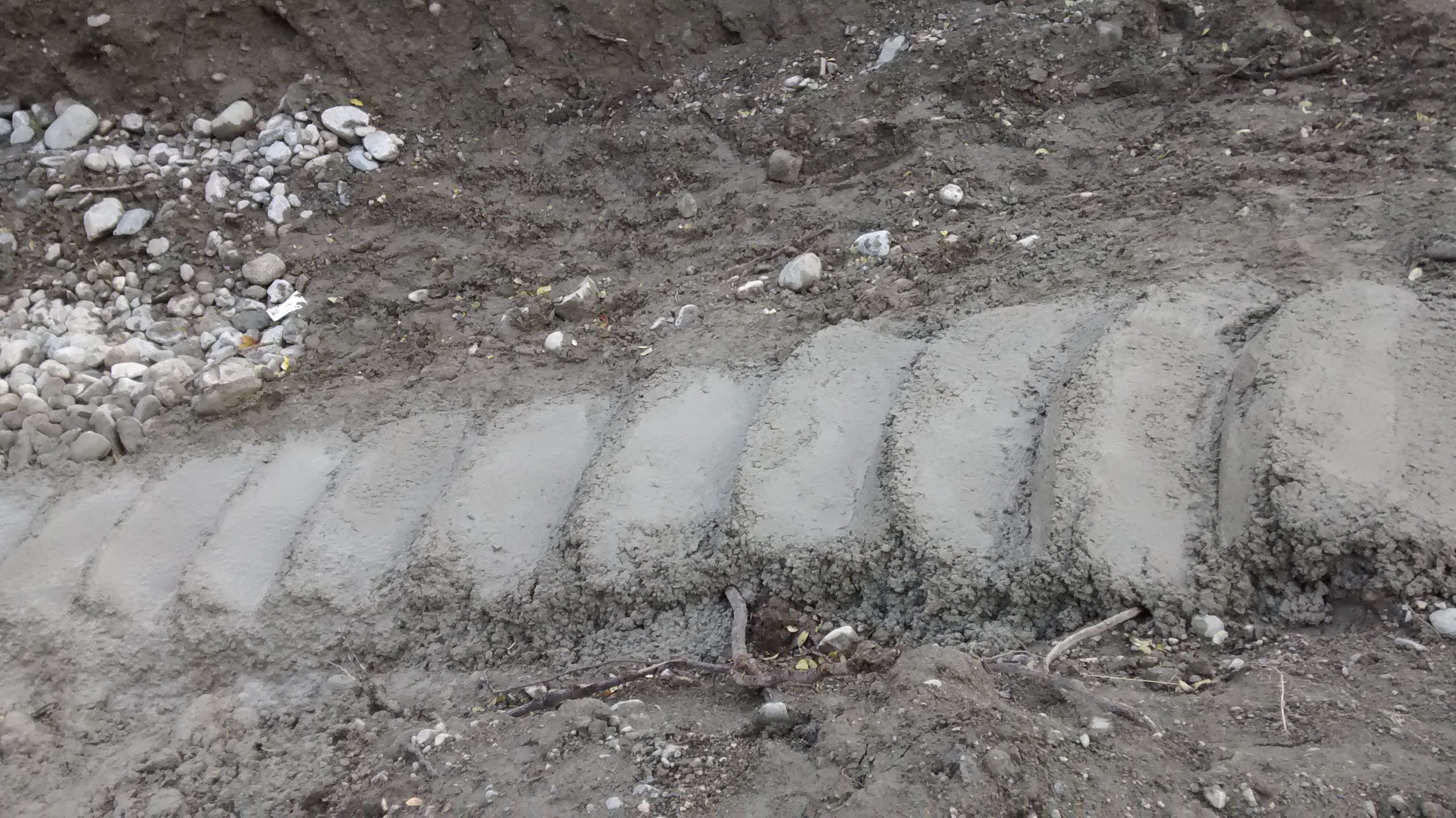

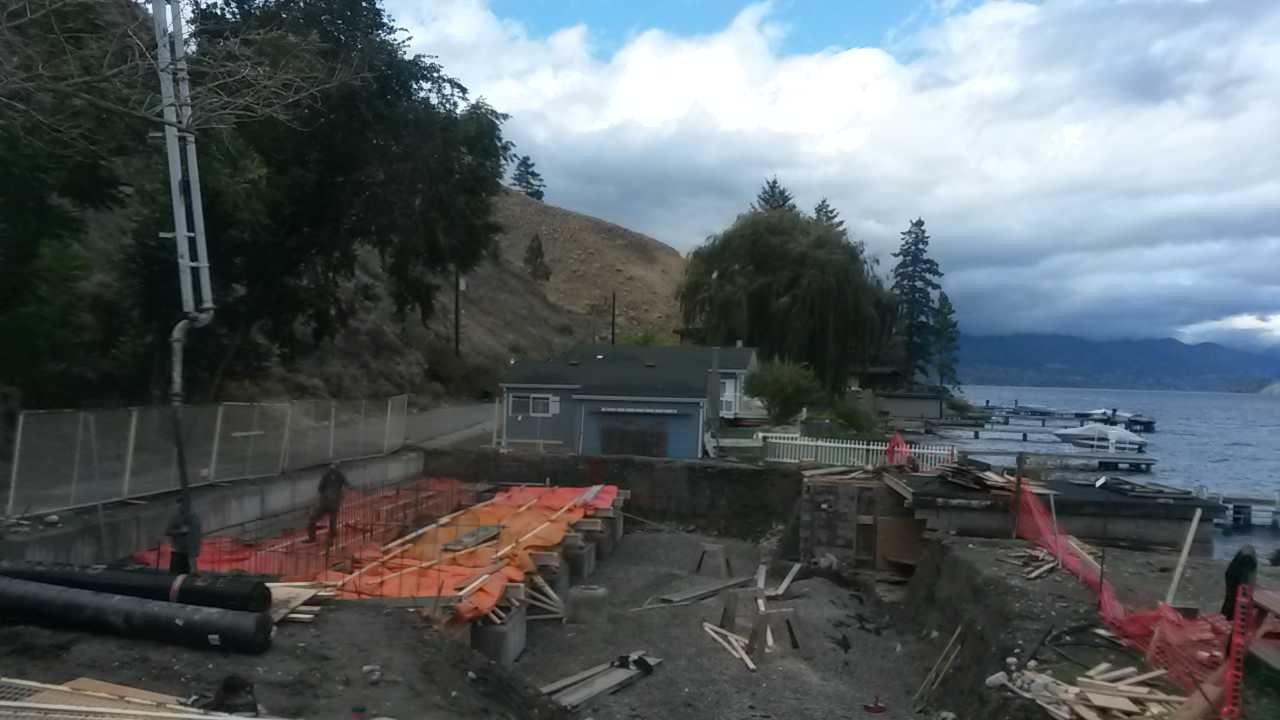

img_20161020_145723 The crew spent most of the day pumping about 8 truck loads of concrete into the forms. Even though the rain held off, the structural engineer insisted that the concrete be covered by insulated tarps. Also the forms cannot be removed until Monday.img_20161020_153737461



The left over concrete was used to make a temporary staircase going down into the hole.

Oct 18 – Footing Rebar was installed

The footing form and rebar installation is complete. Inspections by both RDOS and the structural engineer passed so we are good to start the concrete pour tomorrow morning. The pumper truck will arrive before 8 am and the many concrete trucks will start rolling in at 8:30.

Here are some pictures that John Gregg took at around 1:00 pm this afternoon.

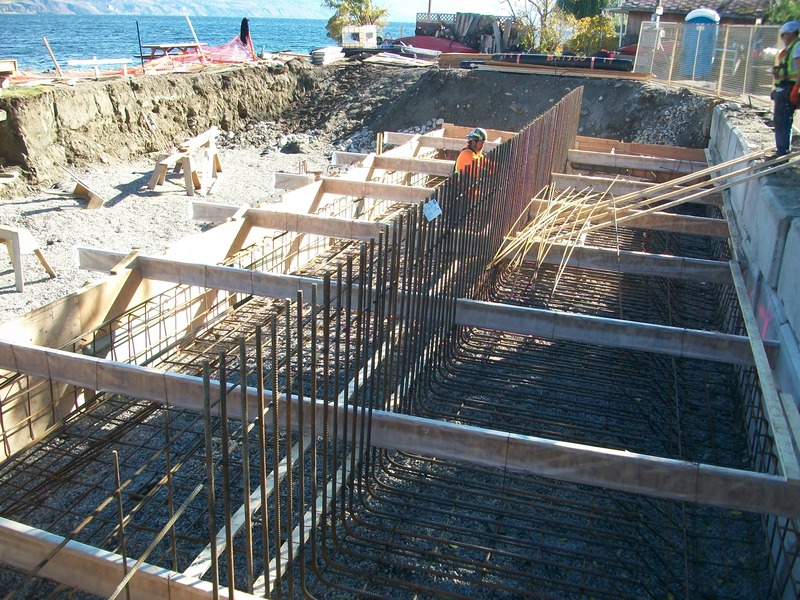

100_1954

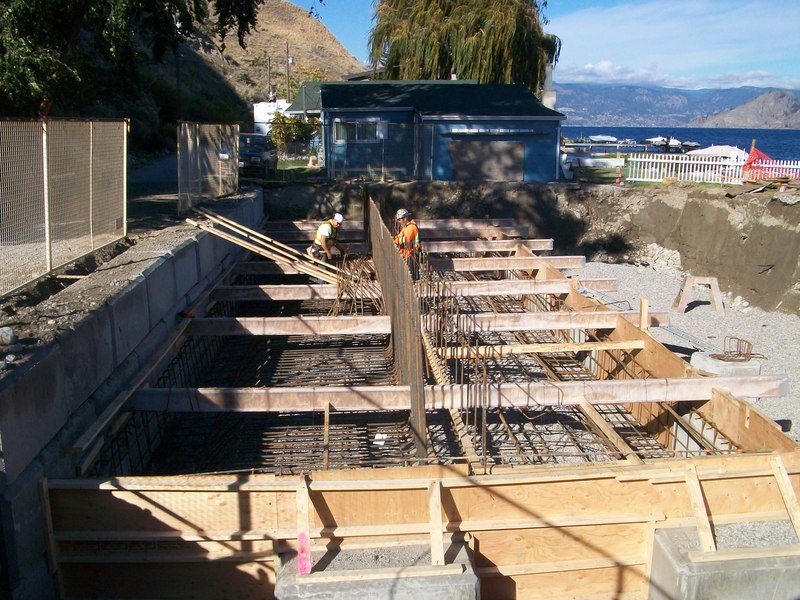

100_1954 100_1955

Oct 18 – New Plan for Concrete Pour

The installation of the rebar will take longer than was first planned. Rather than 1 day, it is now expected to take 2 1/2 days. As a result the rebar people will be done Wednesday morning and the inspections will take place on Wednesday afternoon. The pour of the concrete for the retaining wall footing is now planned to start at 8:30 on Thursday morning.
